Case Road Improvement Project

Share & Bookmark, Press Enter to show all options, press Tab go to next option
Print

case rd_heading

Project Overview

The Case Road Improvement Project aims to improve traffic flow and safety along Case Road, a vital connector between the 215 Freeway and Downtown Perris. This project includes several important infrastructure upgrades, from road and bridge widening to intersection improvements, that will support the region's growth and enhance local access for businesses. The Case Road construction team is working in partnership with the City of Perris to complete the infrastructure upgrades.

Project Details

Benefits

  • Enhanced safety and traffic flow along Case Road, covering approximately 2 miles.
  • Critical upgrades to the intersection of Case Road / Ellis Avenue / Metrolink railroad tracks to improve safety in this growing business corridor.
  • Installation of recycled waterline and potable waterline to boost Perris' water infrastructure and capacity.

Work Hours

Daily | 7 a.m. to 3:30 p.m.

Nighttime and weekend work is permitted to expedite the construction process.

Construction Alert: November 2025

ROAD CLOSURE: E. Ellis Avenue to remain closed between Case Road and S. Redlands Avenue through Spring 2026. Case Road bridge construction is underway, expected completion in Winter 2026

Full Road Closure Information

  • The project closed E. Ellis Avenue to reconstruct the intersection of Case Road / E. Ellis Avenue / Metrolink railroad tracks, which is substantially complete. The road will remain closed while Southern California Edison completes utility undergrounding in the area and Metrolink makes additional track improvements. Re-opening is expected in Spring 2026.

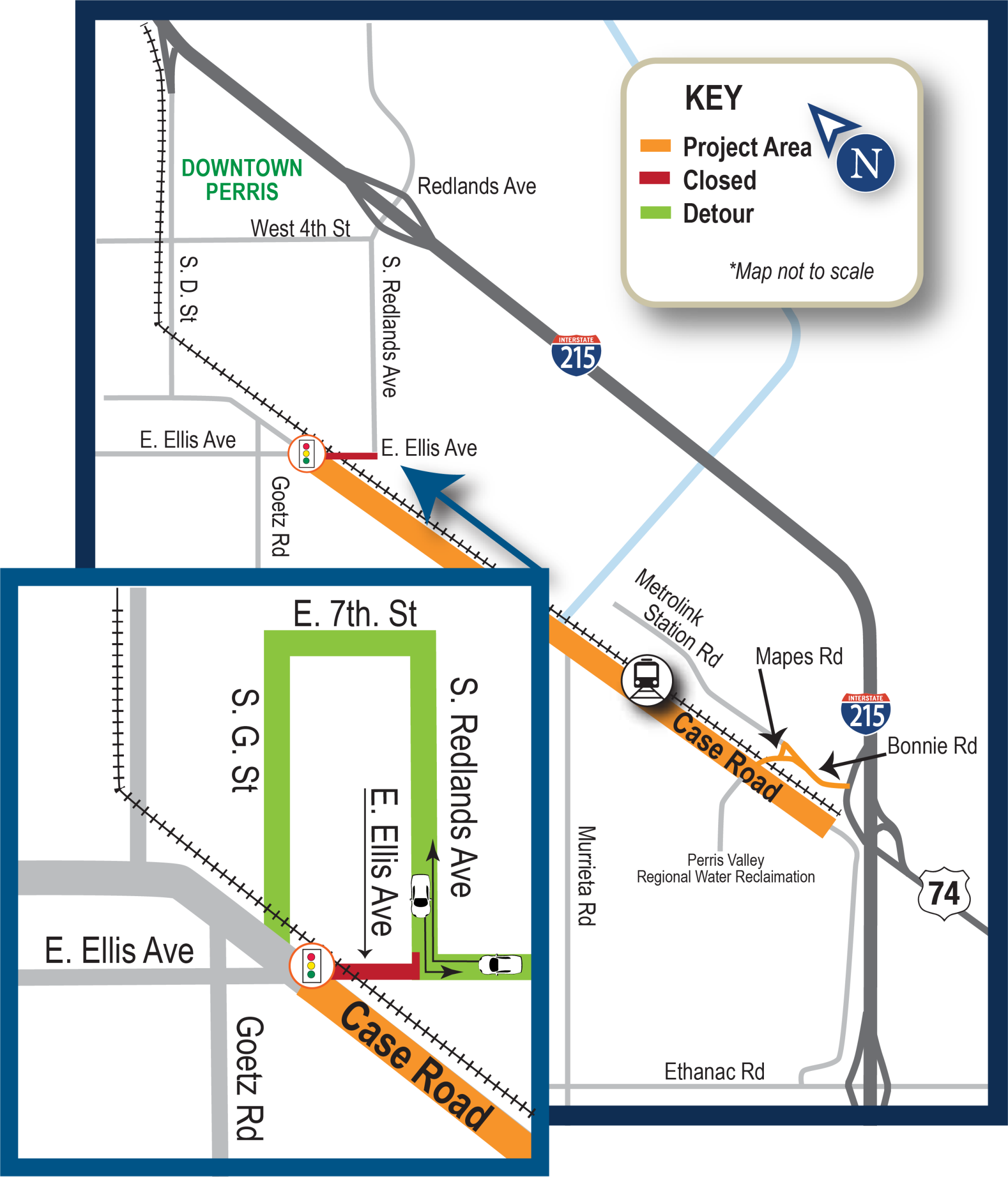

Case map.pullout.detour.10.24

Project Updates

Case Road Bridge

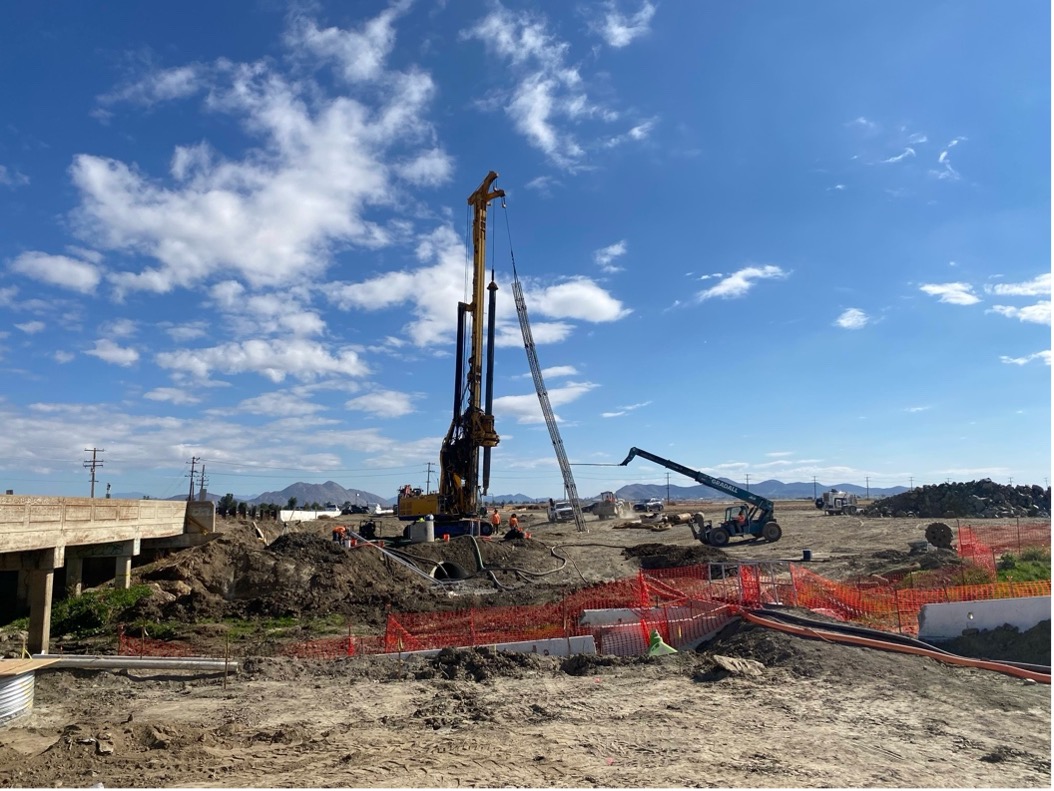

Construction is underway on the Case Road bridge over the San Jacinto River. This new 4-lane bridge will tie-in with Case Road improvements and is expected to be completed in Winter 2026.

Case Road Bridge
Construction is starting on the Case Road bridge foundation with the crane placing steel column cages into the ground.

Minimal Traffic Impacts

  • Traffic capacity will not be impacted on Case Road as motorists will use the existing two-lane bridge while the southern bridge span is constructed.
  • Traffic will switch to the new two-lane southern bridge span when construction begins on the northern bridge span.
  • All four lanes, two in each direction, and a dedicated bike lane will open on Case Road once the bridge is completed.

Case Road Improvements

Crews widened Case Road from 2 to 4 lanes from Mapes to Goetz roads and added new storm drainage; recycled waterlines; concrete sidewalk, curb and gutter; and a dedicated bike lane along the new roadway. Motorists are currently using one lane in each direction during construction on the bridge over the San Jacinto River. Work is 90% complete.

Intersection Improvements

The project reconfigured intersection alignment and will add new traffic signals at the intersections of Case and Murrieta roads, and Case and Mapes roads to improve safety and traffic flow. Work is 90% complete; signal activation is pending.

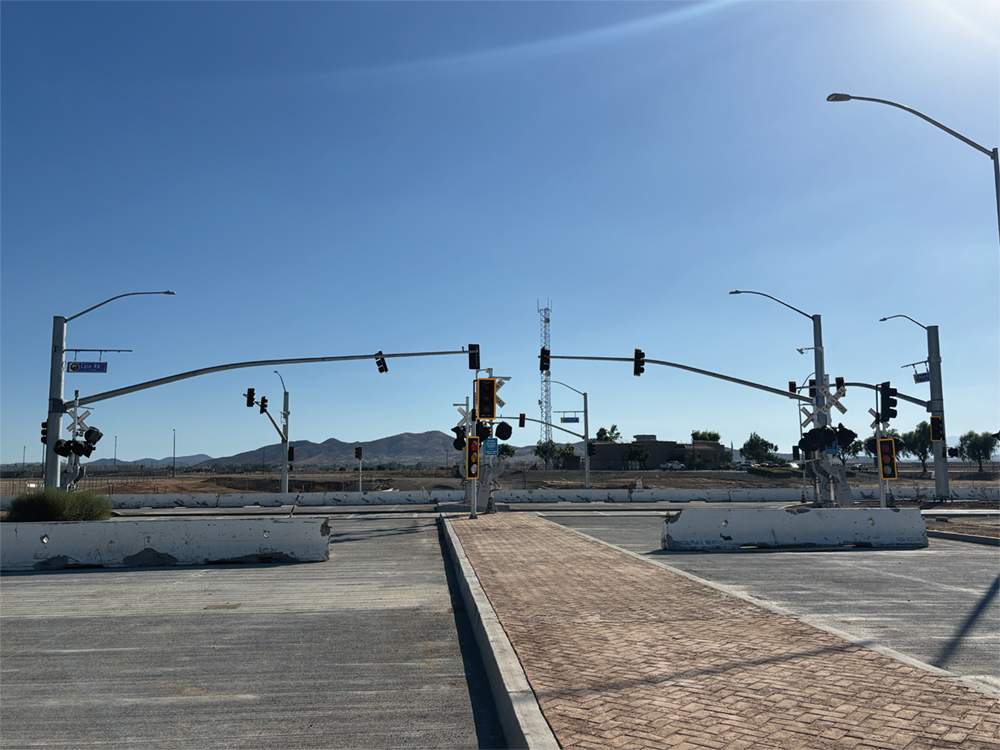

Case Ellis
Safety and traffic flow improvements at the intersection Case and Ellis roads include new traffic signals; railroad track and signaling upgrades; new concrete center median; and the installation of new concrete sidewalk, curb and gutter.

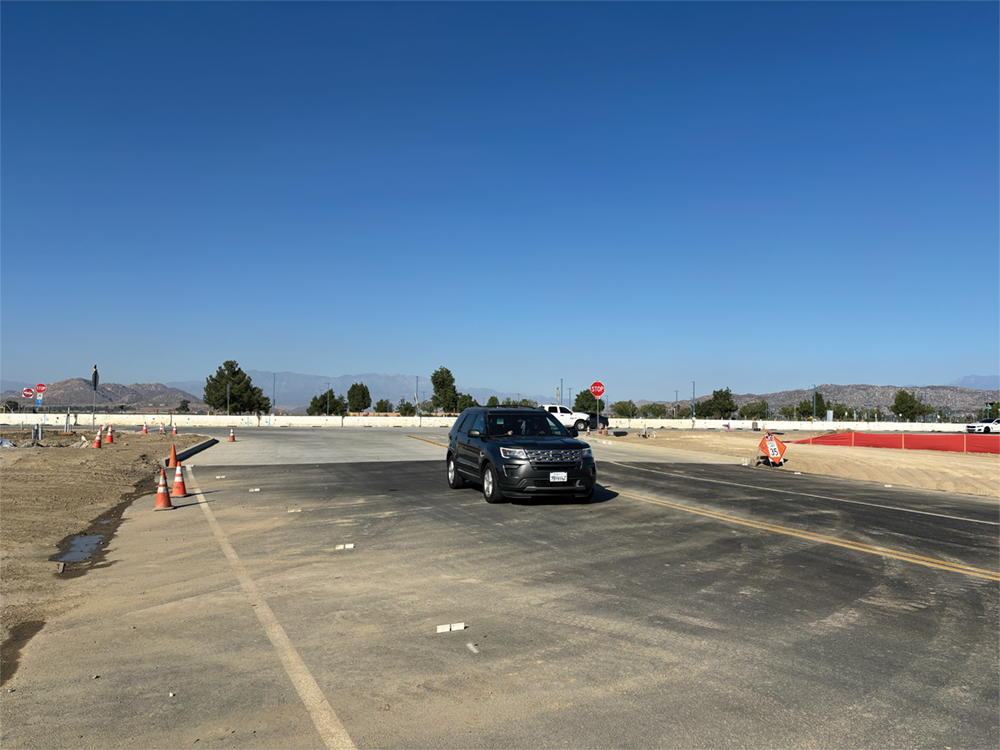

 Case Murrieta
Motorists are using the new intersection alignment at Case and Mapes road.

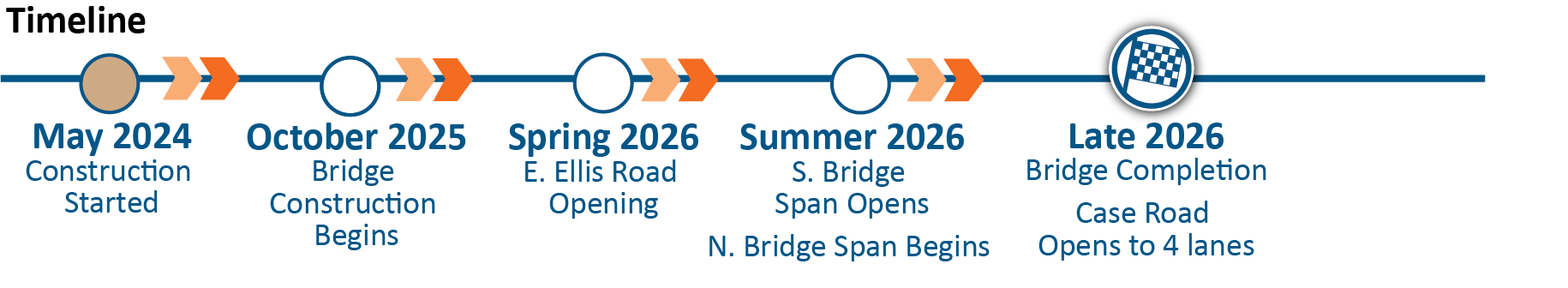

case timeline.10.24
